MILITARY ROAD CAPACITY AND SAFETY

Project Overview

Label Value
Status Upcoming Projects
Project Details 0512019
RTC Project Manager (PM) Austin McCoy, P.E.
RTC Engineering Department (775) 335-1824
Design Firm Lumos and Associates
Construction Contractor Spanish Springs Construction

Project Description

The RTC is beginning construction to improve and widen Military Road between Lemmon Drive and Lear Boulevard in Reno. The project will add safety, roadway capacity, and improve bicycle and pedestrian facilities to increase multimodal transportation options in the North Valleys area of our community. The project will also incorporate drainage improvements, provide access control, and modify intersections to improve safety and accessibility for everyone. This project represents a significant investment of approximately $35 million into our community, funded with Regional Road Impact Fees.

Construction Schedule:

June 2026- Fall 2027

Construction Overview:

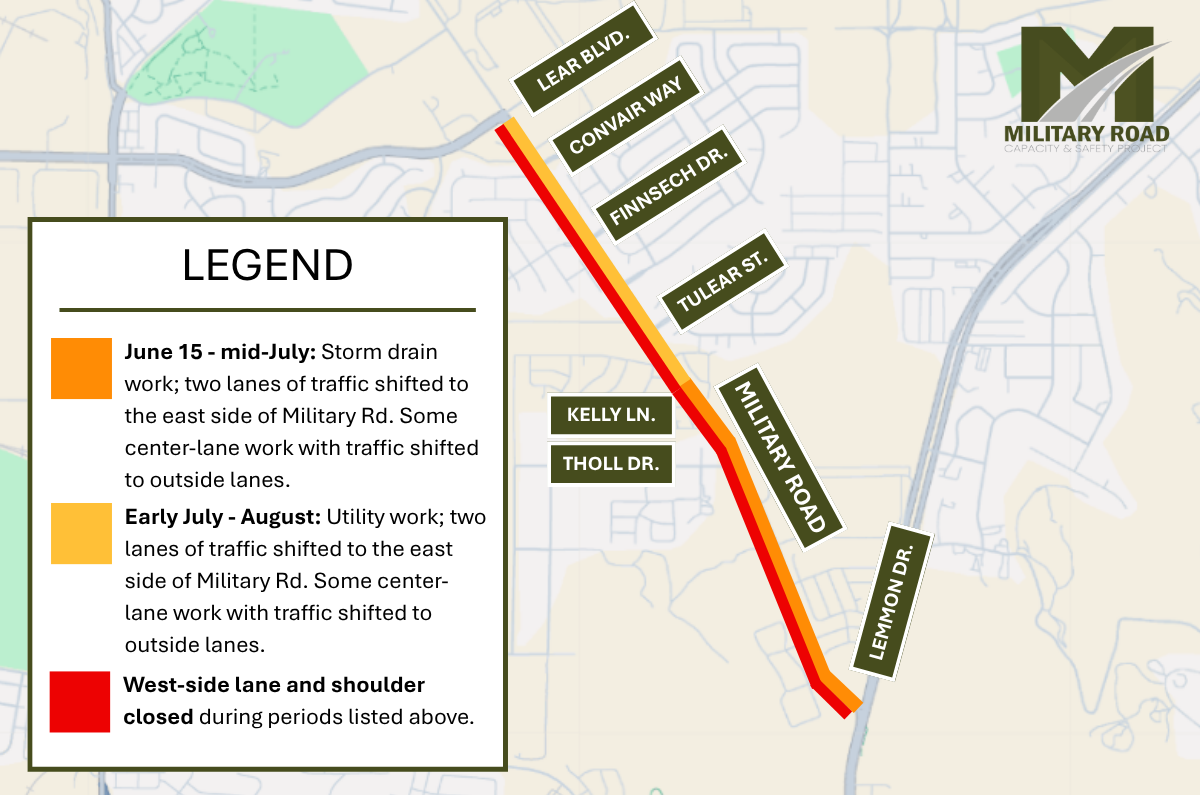

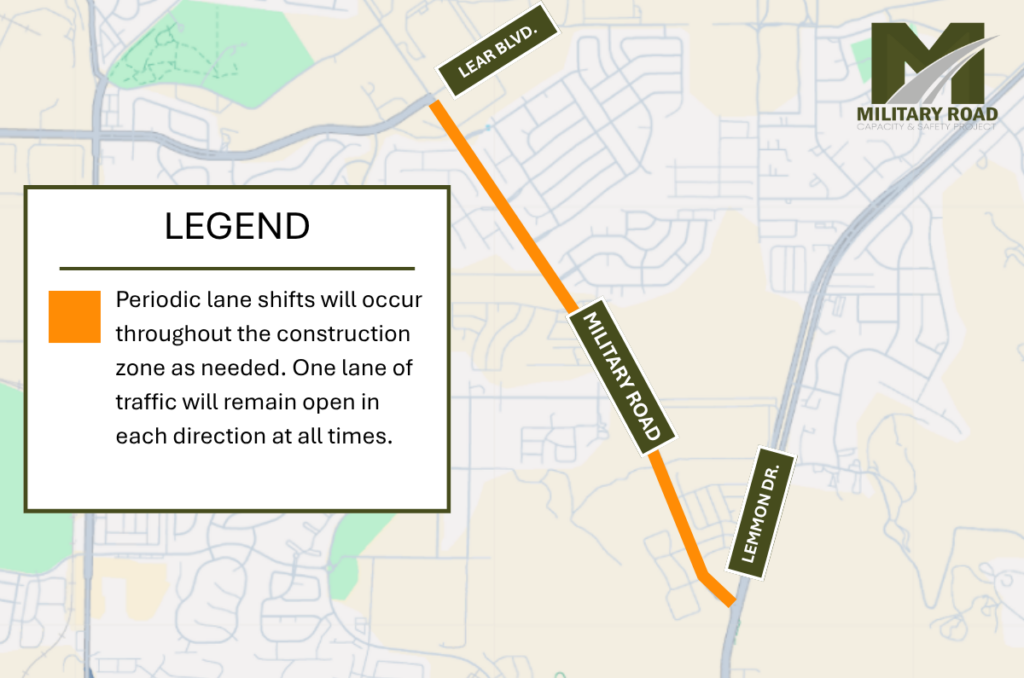

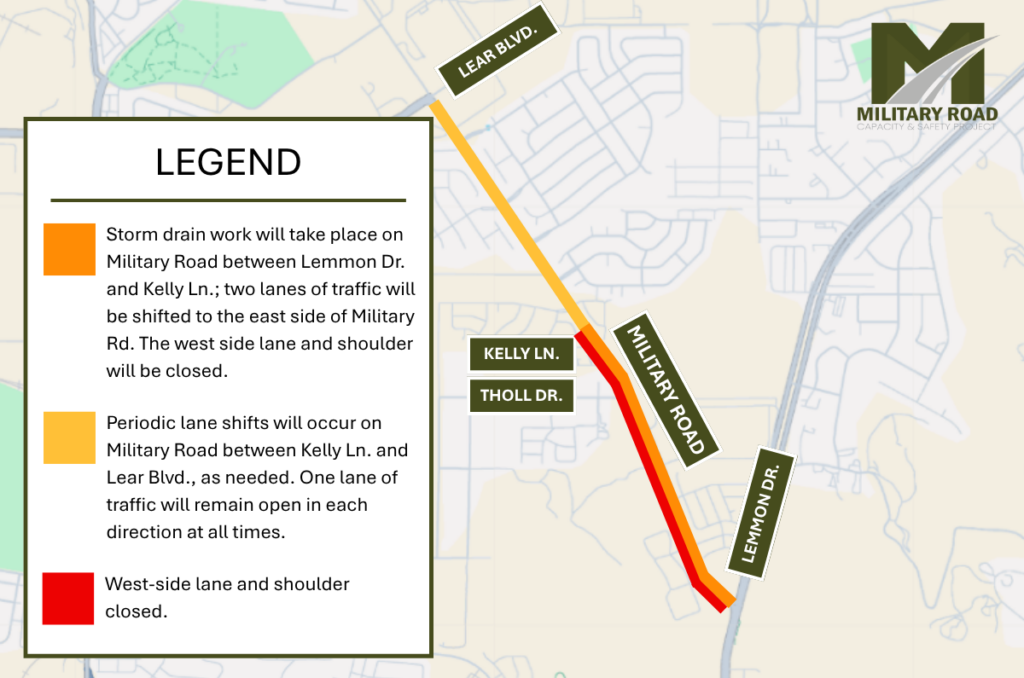

Construction will begin with underground utility and storm drain improvements, followed by construction of the west-side shared-use path, curb and gutter, and side street work. Once complete, crews will transition to similar improvements on the east side of the corridor. Paving and roadway widening are scheduled for 2027 and will take place in four separate work zones to help manage traffic and maintain access. Throughout construction, at least one lane of traffic in each direction will remain open, and access to homes and businesses will be preserved. Work will generally occur Monday through Friday from 7 a.m. to 7 p.m., with weekend work scheduled as needed and communicated in advance. The project is anticipated to be completed in fall 2027.

Project Hotline: (775) 235-2686
Project Email: MilitaryRoadProject@rtcwashoe.com

Project Purpose:
Primary Goals

  • Improve safety
  • Increase capacity
  • Enhance multimodal access

Roadway Design:

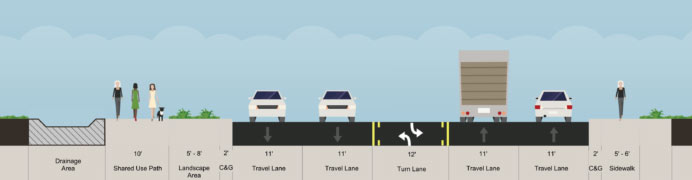

cross section for Military Road

  • 4-lane widening from Lemmon Drive to Lear Boulevard.
  • Includes center turn lanes where appropriate
  • Shared-Use Path (separated from roadway) and pedestrian facilities are included
  • Minimized existing sidewalk removal

May 2026 – Public Meeting

English:

Spanish:

Latest News

The RTC, in cooperation with the City of Reno, has completed design and the project was awarded to Spanish Springs Construction. Construction anticipated to begin in June 2026.

Schedule

Planning: Complete
Environmental:
2023 – 2024
Preliminary Design:
 Summer 2023 – Spring 2024
Final Design:
Summer 2024 – Fall 2025
Construction:
2026 – 2027

Financial Information

Total Project Estimate: $38,104,438
Funding Source:
 RTC Regional Road Impact Fee (RRIF)

To bid, click here:  https://rtcwashoe.procureware.com/login

Project Map

Project Map
