WHITE FIR REHABILITATION

Project Overview

Label Value
Status Active Projects
Project Details 212084
RTC Project Manager (PM) Austin McCoy, P.E.
RTC Engineering Department (775) 335-1824
Design Firm DOWL Engineering
Construction Contractor Granite Construction

Project Description

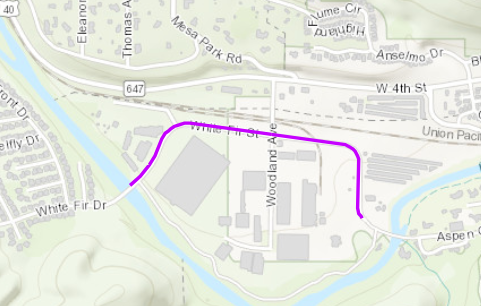

The project will rehabilitate the pavement on White Fir Street from the east bridge abutment to Woodland Avenue and Woodland Avenue to the culdesac.

Latest News

Granite Construction began work on October 19, 2026. Crews are currently locating existing utilities and plan to begin roadway construction during the week of October 26, 2026. We know there have been frustrations for the public and we apologize and are working to minimize impacts. RTC Project Managers will continue to provide updates to the public as the project moves forward.

Schedule

Planning: N/A
Environmental: N/A
Preliminary Design: November 2024 – March 2025
Final Design: March 2025 – October 2025
Construction: Summer – Fall 2026

Financial Information

Total Project Estimate: $4,858,041
Funding Source: RTC Fuel Tax

To bid, click here:  https://rtcwashoe.procureware.com/login
